The weekly federal-spending brief. One email a Sunday. Free. No tracking.
The BuildoutBeta

Hanford Gets $10.6B, Texas Schools Get $7.6B, and the Federal Ledger Tells Two Very Different Stories

Week of April 13–19, 2026. Published April 19, 2026. Auto-generated from The Buildout's pipeline; not edited.

Hanford Gets $10.6B, Texas Schools Get $7.6B, and the Federal Ledger Tells Two Very Different Stories

Week of April 13–19, 2026 · Issue published April 19, 2026.

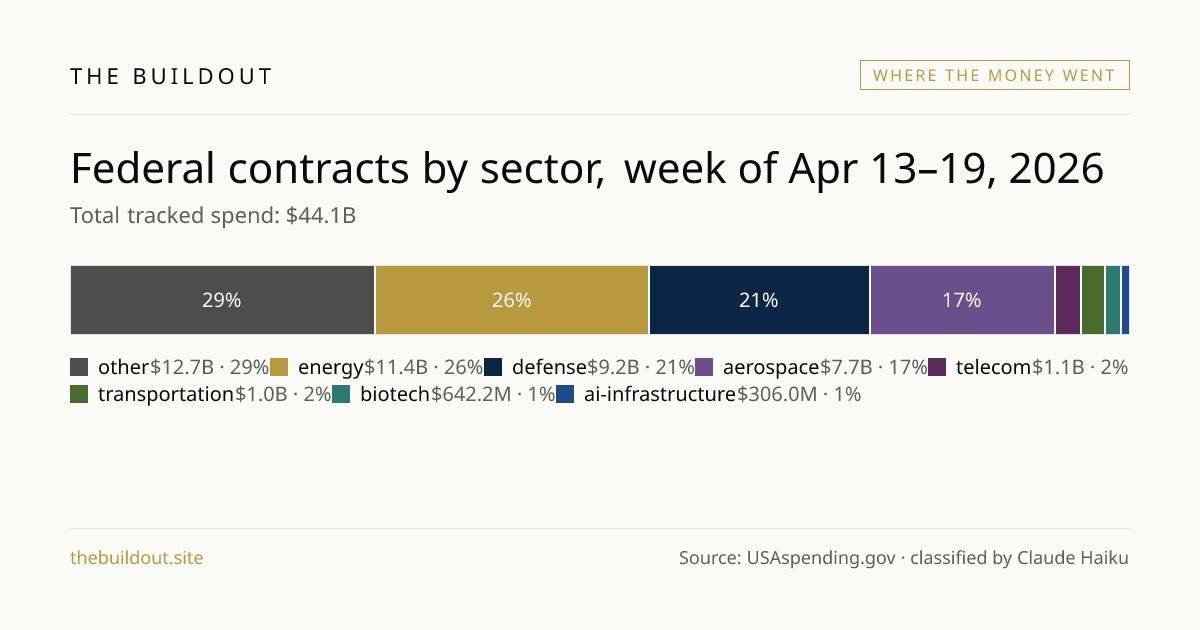

The week of April 13–19 closed with $89.6 billion in federal obligations — the fourth-largest weekly total in the trailing nine-week window, running $32.7 billion below the 12-week average of $122.3 billion. The single largest action was a $10.57 billion re-up for Washington River Protection Solutions LLC to manage the Hanford Site tank farms, the most contaminated nuclear waste complex in the Western Hemisphere. That one contract alone consumed 11.8 cents of every dollar obligated this week. Alongside it, the Department of Agriculture pushed $7.6 billion in Child Nutrition Program block grants to Texas and New York in a single day, and HHS committed $2.78 billion to Maximus Federal Services for Medicare and Medicaid contact center operations. The week's tension: a federal government simultaneously trying to contain a 75-year-old nuclear mess, feed 50 million schoolchildren, and keep the lights on at the VA — all while total weekly spend runs well below its recent pace.


The Hanford Anchor: DOE's $10.6 Billion Bet on Washington River Protection Solutions

The Department of Energy's $10,572,204,772 obligation to Washington River Protection Solutions LLC, executed April 15, is the closest thing to a structural commitment the federal government makes in the environmental remediation space. Hanford is not a project with a finish line anyone alive today will see. The site in southeastern Washington State holds 56 million gallons of radioactive and chemical waste in 177 underground tanks — the legacy of plutonium production for the U.S. nuclear weapons program from World War II through the Cold War. The tank farms are the most hazardous portion of a cleanup enterprise that the DOE has been managing, in various contractual configurations, since the late 1980s.

Washington River Protection Solutions has held the tank operations contract since 2008, when it was formed as a joint venture to take over from Fluor Hanford. The current action, dated April 15, carries a period-of-performance end date listed as February 23, 2025 — a retroactive or bridge-period obligation that signals the contract is either in extension or mid-re-compete. That detail matters: when a contract of this scale shows a performance end date already in the past, it typically means the government is funding continued operations while a successor vehicle is negotiated. DOE has not publicly announced a formal re-compete for the Hanford tank farms management contract, which means the next award — when it comes — will be one of the largest single environmental services procurements in federal history.

The energy sector accounted for $12.05 billion in total obligations this week across 14 awards, making it the second-largest sector by dollar volume behind the catch-all "other" category. That concentration — 14 awards producing $12 billion — reflects the lumpy, high-dollar nature of DOE's management and operations contracting model, where a handful of national laboratory and site contracts dwarf everything else in the portfolio.

What's at stake at Hanford extends beyond the contract vehicle. The site's Waste Treatment and Immobilization Plant, built by Bechtel National, has consumed more than $17 billion in construction costs and remains years from full operations. The tank farms that Washington River Protection Solutions manages are the upstream problem: waste must be retrieved from those tanks and fed into the vitrification plant. Any disruption in tank farm operations — a leak, a safety incident, a contractor transition — cascades directly into the broader cleanup timeline. The GAO has flagged Hanford's cost and schedule risks repeatedly over the past decade. Watch for DOE to issue a formal solicitation for the next tank operations contract before the end of fiscal year 2026; the retroactive period end date on this week's action suggests the clock is already running.


Texas and New York Collect $7.6 Billion in School Nutrition Grants — in One Day

On April 17, the Department of Agriculture obligated three separate awards to the Texas Department of Agriculture totaling $7,577,467,013, plus $1,178,721,490 to the New York State Education Department, all under the Child Nutrition Program block grant authority. The Texas awards alone — $2,657,442,707, $2,598,363,588, and $2,321,660,718 — represent one of the largest single-day concentrations of nutrition assistance funding to a single state in recent memory. The period-of-performance dates on the three Texas awards span fiscal years 2021 through 2026, which indicates USDA is catching up on multiple grant years simultaneously, a pattern that sometimes reflects delayed appropriations processing or state-level reconciliation.

The Child Nutrition Program funds school breakfast and lunch for roughly 30 million children nationally, with Texas and California — which received $1,508,885,048 through the California Department of Education on the same day — representing the two largest state recipients by enrollment. The combined $10.07 billion in CNP obligations on April 17 alone accounts for 11.2 percent of the week's total federal spend.

This matters for a reason that goes beyond the dollar size. Congress has two active CBO-scored bills touching child care and nutrition program integrity: H.R. 7722, the Child Care Integrity Monitoring Act of 2026, and H.R. 7725, the Stop Child Care Fraud Act of 2026, both reported by the House Committee on Education and Workforce on April 6 and scored by CBO on April 17. Neither bill has been publicly detailed in CBO's summary beyond its committee origin, but the simultaneous scoring of two fraud-and-integrity bills against the backdrop of a $10 billion single-day nutrition grant push is not coincidental timing. House Education and Workforce has been building a paper trail on improper payments in federal nutrition and child care programs. When those bills move to the floor — likely before the August recess — the $7.6 billion Texas grant will be exhibit A in the debate over whether block grant structures have adequate oversight mechanisms.

The California award, routed through the Department of Education rather than the state agriculture department, reflects California's administrative structure for CNP and is consistent with prior-year grant routing. Watch for USDA's Food and Nutrition Service to publish its annual improper payment rate for the National School Lunch Program, typically released in the fall, which will land in the middle of whatever legislative action follows these CBO scores.


Maximus, Optum, and the $3.9 Billion Week for Federal Healthcare Administration

Two contracts this week illuminate how the federal government actually delivers healthcare to its largest beneficiary populations — not through direct service, but through a layered contractor infrastructure that processes claims, answers phones, and manages benefits at industrial scale.

HHS obligated $2,779,736,793 to Maximus Federal Services, Inc. on April 16 for contact center operations supporting Medicare and Medicaid. Maximus is the dominant player in federal beneficiary services contracting; the company holds the 1-800-MEDICARE contract and operates contact centers that handle hundreds of millions of beneficiary interactions annually. The $2.78 billion obligation, with a period ending September 10, 2026, is consistent with a bridge or option-year exercise on an existing vehicle rather than a new award. Maximus's federal health segment has faced scrutiny over call wait times and first-call resolution rates — metrics that CMS tracks but does not routinely publish in accessible form.

Separately, the Department of Veterans Affairs obligated $1,102,850,655 to Optum Public Sector Solutions, Inc. on April 15 for what the award description labels "EXPRESS REPORT:R3 FY26 1ST QTR OCT" — bureaucratic shorthand for a quarterly healthcare administration and benefits processing payment under the VA's Community Care Network. Optum, a subsidiary of UnitedHealth Group, administers the VA's community care referral and claims processing infrastructure, which routes veterans to non-VA providers when VA facilities cannot meet their needs. The $1.1 billion quarterly payment implies an annualized run rate of roughly $4.4 billion for Optum's VA work alone.

Together, Maximus and Optum collected $3.88 billion this week for healthcare administration — more than the entire defense sector's $9.49 billion in 41 awards, when measured on a per-award basis. The concentration of federal health administration in two contractors raises a structural question that neither CMS nor VA has answered publicly: what is the contingency plan if either contract is disrupted? The VA's Community Care Network has already experienced one major contractor transition, when TriWest Healthcare Alliance and Optum split the country into regional networks in 2019. A re-compete on either the Maximus Medicare contact center vehicle or the Optum CCN contract would be among the most consequential federal health procurements of the decade. The Optum award's period end date of October 31, 2025 — again, already past — signals the VA is operating on a bridge, and a formal re-compete notice should be expected within the next two quarters.


Raytheon Lands $1.2 Billion for NASA's Next Climate Eye in the Sky

NASA obligated $1,224,555,500 to Raytheon Company on April 17 for engineering services and development of the Visible Infrared Imager Radiometer Suite instrument — VIRS — with a period running through March 1, 2029. VIRS is the primary imaging instrument for the Joint Polar Satellite System, the backbone of U.S. operational weather forecasting and climate monitoring from low Earth orbit. The instrument measures reflected solar and emitted thermal radiation across 22 spectral bands, feeding data to NOAA's numerical weather prediction models and to climate researchers globally.

The $1.22 billion award lands in a week where aerospace accounted for $7.92 billion across 32 awards — the third-largest sector by volume. Raytheon's VIRS work sits at the intersection of two federal priorities that are currently in tension: the administration's stated commitment to weather and climate data infrastructure, and ongoing pressure to reduce discretionary spending. JPSS satellites cost approximately $1 billion each to build and launch; the ground segment and instrument development contracts like this one add another layer of cost that rarely receives the same public attention as the satellite bus itself.

The State Department's $2,309,491,423 award to Xator LLC for CARE Logistical Support Services, executed April 13, rounds out the week's largest defense-adjacent obligations. Xator — a defense and security services firm — holds the CLSS contract, which supports logistics for U.S. government humanitarian and contingency operations. The $2.31 billion obligation with a period end date of February 28, 2026 follows the same retroactive pattern seen in the Hanford and Optum awards, suggesting a bridge or extension rather than a new competitive award. The CLSS contract has historically supported operations in conflict-adjacent environments; its re-compete, when it comes, will draw interest from every major defense logistics firm.


Oversight Feed: GAO on Guam, CBO on Foreign Policy, and the FAA's New Drone Enforcement Hammer

The week's oversight and regulatory output carried three threads worth tracking separately.

GAO-26-107811, published April 17, examined customs operations in Guam and found that the Customs and Quarantine Agency maintains only paper-based records of customs transactions — a finding that GAO said limits efficiency, may compromise data reliability, and results in reduced revenue. The report evaluated alternative customs models for Guam, including potential integration with U.S. Customs and Border Protection. For a territory that serves as a logistics hub for U.S. military operations in the Indo-Pacific, the customs infrastructure gap is not merely an administrative inconvenience; it is a supply chain security vulnerability. GAO's findings will feed directly into any congressional discussion about Guam's role in the Pacific deterrence posture.

On the legislative scoring front, CBO published four foreign-policy bill scores on April 17: H.R. 7641 (Transparency in Foreign Assistance Act), H.R. 7653 (Biodefense Diplomacy Enhancement Act), H.R. 7654 (Advance Global Health Act), and H.R. 7674 (Venezuela Democratic Transition Strategy Act), all ordered reported by the House Foreign Affairs Committee on March 26. None of the CBO summaries in this week's data include cost estimates, but the clustering of four foreign assistance and diplomacy bills through committee in a single markup — and their simultaneous CBO scoring — suggests House Foreign Affairs is building a package for floor consideration. The Venezuela bill in particular carries geopolitical weight given current U.S. policy posture toward Caracas.

The Federal Register's most operationally immediate item this week is the FAA's new Drone Expedited and Targeted Enforcement Response program — DETER — published April 17. DETER formalizes an expedited enforcement track for small UAS operators who violate FAA regulations, with the explicit goal of increasing both the speed and volume of enforcement actions. The program takes effect immediately upon publication. For commercial drone operators, this is a material change in risk calculus: the FAA has historically been slow to pursue civil penalties against small UAS violators, and DETER removes that buffer. The agency also proposed establishing Class E airspace at Lane Airpark in Rosenberg, Texas — a routine action, but one that signals continued FAA infrastructure buildout in the Houston metro corridor.

The presidential document continuing the national emergency on Russian-affiliated vessel anchorage and movement, published April 17, extends an authority first invoked in 2022. Its continuation is procedurally unremarkable but serves as a reminder that the sanctions infrastructure around Russian maritime commerce remains active and administratively maintained.


On the Record

"We, the U.S. Fish and Wildlife Service (Service), propose to list the Jamaican kite swallowtail (Eurytides marcellinus), a butterfly species from Jamaica, as an endangered species under the Endangered Species Act of 1973, as amended (Act)." — Interior Department, proposed rule, April 17, 2026

"This action proposes to establish Class E airspace at Lane Airpark, Rosenberg, TX." — Transportation Department, Federal Aviation Administration, proposed rule, April 17, 2026

"The Department of State is correcting a rulemaking that appeared in the Federal Register on March 13, 2026." — State Department, rule, April 17, 2026


What to Watch

  • Northrop Grumman Systems Corporation / NASA — $4,425,784,857 contract expires June 30. This is one of NASA's largest active vehicles; a re-compete notice or sole-source justification should appear in SAM.gov within the next 30 days.
  • Jefferson Science Associates / DOE — $3,282,976,341 contract at Jefferson Lab expires May 31. DOE's Office of Science has not published a successor solicitation; watch for a bridge extension or competitive RFP by mid-May.
  • Association of Universities for Research in Astronomy / NASA — $2,511,478,245 contract expires June 30. AURA operates the National Optical-Infrared Astronomy Research Laboratory; a re-compete here would restructure how NASA funds ground-based observatory infrastructure.
  • Bollinger Shipyards Lockport / DHS — $2,075,724,899 contract expires June 2. Bollinger builds Coast Guard cutters; any delay in re-award directly affects the USCG's fleet recapitalization timeline.
  • House Education and Workforce — CBO scores for H.R. 7722 and H.R. 7725 (child care fraud and integrity) are now in hand. Floor scheduling is the next trigger; watch for a markup or rule filing before Memorial Day.
  • House Foreign Affairs package — Four CBO-scored bills (H.R. 7641, 7653, 7654, 7674) cleared committee simultaneously. A floor package combining foreign assistance transparency and biodefense diplomacy is the logical next step.
  • FAA DETER enforcement program — Now in effect. First enforcement actions under the expedited track will establish precedent for penalty amounts and timeline; watch for FAA civil penalty orders in the docket over the next 60 days.
  • Hanford tank farms re-compete — The retroactive period end date on the Washington River Protection Solutions award signals a bridge. DOE has not published a successor solicitation. A formal RFP would be the largest environmental services procurement of fiscal year 2026.

The $89.6 billion week tells a story about a federal government running on bridge contracts and batch-processed grants — Hanford on extension, Optum on extension, Maximus likely the same, and $10 billion in school nutrition grants covering multiple fiscal years in a single day. The structural question underneath all of it is whether the re-compete pipeline — Northrop at NASA, Jefferson Lab at DOE, Bollinger at DHS — can clear before the fiscal year ends in September without triggering another round of bridge extensions that obscure true program costs. Congress's simultaneous push on child care fraud oversight and foreign assistance transparency, now CBO-scored and committee-cleared, will force at least some of those cost questions into the open before summer recess.


The Buildout · Issue covering 2026-04-13 – 2026-04-19. Generated May 15, 2026 at 5:26 UTC. Data: USAspending.gov, Federal Register, Grants.gov, agency RSS, GAO, CBO. Subscribe · Archive · Methodology.
